Fundraising Risk Register Template for Nonprofits

Fundraising Risk Register Template for Nonprofits

A working risk library with 20+ scored risks, named owners, and board-ready rows that actually connect incidents back to controls

Most nonprofit risk registers die in a shared drive. Someone builds one before an audit, lists a dozen vague risks like "reputational damage" and "donor attrition," assigns everything to "the ED," and never opens it again. Then a chargeback spike or a grant clawback hits and nobody can point to the control that was supposed to catch it.

The problem isn't that teams don't care about risk. It's that the register gets built as a compliance artifact instead of an operational tool. A register that actually works tells you three things at a glance: what can go wrong, who owns stopping it, and whether your controls are holding. When an incident happens, you should be able to trace it backward — incident → failed control → accountable owner — in under a minute.

This piece gives you a fundraising-specific risk library you can lift directly into your own fundraising risk register nonprofit workflow, with likelihood/impact scoring, the controls that matter, owner assignments, and a board-report structure that maps real incidents to real accountability.

Why most fundraising risk registers fail in practice

Before the library, it's worth naming the failure patterns, because they're predictable.

The scoring is cosmetic. Teams rate everything "medium." When your heat map is a wall of yellow, you've lost the one thing a register is supposed to produce: prioritization. A register with twenty risks where six are red is far more useful than one where all twenty are "medium-high."

Owners are titles, not people. "Development team" owns nothing. When a pledge reconciliation gap surfaces, you need a name — the person who gets the Slack message and the person whose review the board will ask about.

Controls are aspirational. "We train staff on data privacy" is not a control you can test. "Quarterly access review of the CRM with a signed-off report" is. The difference is whether you can prove it happened.

Incidents never loop back. A dispute happens, someone handles it, and the register stays frozen. The whole value of a register is that incidents update your likelihood scores and expose which controls failed.

Keep these four failures in mind as you read the library. Every column below exists to prevent one of them.

How to score (so your heat map means something)

Use a simple 1–5 scale for likelihood and impact, then multiply for a priority score (1–25). The trick is defining the anchors clearly enough that two different staff members score the same risk roughly the same way.

Likelihood anchors:

  1. 1 – Rare

    Hasn't happened and no realistic path to it this year

  2. 2 – Unlikely

    Possible but no recent near-misses

  3. 3 – Possible

    Has happened to peer orgs or once to you

  4. 4 – Likely

    Happens occasionally, you've had near-misses

  5. 5 – Almost certain

    Recurring, you expect it this year

Impact anchors (tie these to dollars and reputation, not vibes):

  1. 1 – Minor

    Under ~$1k or an internal-only hiccup

  2. 2 – Low

    ~$1k–$5k or a single donor affected

  3. 3 – Moderate

    ~$5k–$25k, a grant reporting correction, or a handful of donor complaints

  4. 4 – Major

    ~$25k–$100k, a grant at risk, or local press

  5. 5 – Severe

    Six figures, loss of a major funder, regulatory exposure, or board-level reputational damage

One thing worth flagging: small teams consistently under-score likelihood on the quiet operational risks — reconciliation drift, data decay — and over-score the dramatic ones like fraud or breach. The quiet ones are what actually drain you.

The fundraising risk library (20+ scored risks)

Here's the core library. Treat the scores as a realistic starting point for a small-to-mid nonprofit — adjust to your reality. "L" is likelihood, "I" is impact, "Score" is L×I.

#RiskLIScorePrimary ControlOwner
1Online/offline gift reconciliation drift4312Monthly tie-out of processor payouts to CRM, signed offFinance Lead
2Chargebacks & donation disputes mishandled4312Dispute runbook with evidence-capture SLADonations Ops
3Restricted funds spent against wrong purpose3515Fund tagging at intake + quarterly restriction reviewFinance Lead
4Grant reporting missed or inaccurate3412Grant calendar with milestone alerts + pre-submission reviewGrants Manager
5Donor PII breach / unauthorized access2510Role-based CRM access + quarterly access reviewData Owner
6Receipt/acknowledgement non-compliance (IRS substantiation)3412Automated receipts with required language + audit sampleDonations Ops
7Pledge revenue recognized but never collected4312Aging report + 48–72hr pledge verification routineDevelopment Dir.
8Major donor concentration (over-reliance)3515Concentration ratio tracked quarterly + diversification planDevelopment Dir.
9Platform migration data loss/corruption2510Pre-migration audit + canonical mapping + rollback criteriaData Owner
10Duplicate/decayed donor records428Monthly dedupe + hygiene auditData Owner
11In-kind donations mis-valued or unrecorded339Valuation policy + chain-of-custody logFinance Lead
12Matching gifts never captured/claimed428Capture at gift + employer verification workflowDonations Ops
13Event/auction cash & offline gifts unreconciled339Day-of gift logs + post-event reconciliation templateEvents Lead
14Vendor/processor outage during campaign248Backup payment path + SLA in vendor contractOps Manager
15Consent/opt-out violations (email, calls)3412Consent tracking in CRM + suppression enforcementData Owner
16Securities/non-cash gift mishandling248Intake checklist + brokerage confirmation stepFinance Lead
17Fraudulent/stolen-card donations339Velocity rules + flag-and-review thresholdDonations Ops
18Tribute/memorial gift family errors339Tribute workflow with notification verificationDonations Ops
19Fundraising cost misattribution (overhead)339Activity-based costing + quarterly reviewFinance Lead
20Key-person dependency (one person holds the CRM)4416Documented runbooks + cross-training + access backupED
21Donor data used without governance policy3412Data governance policy + RACI + audit playbookData Owner
22Recurring giving silent attrition (failed cards)4312Dunning workflow + card-updater + retry logicDonations Ops
23Impact reporting inaccuracies to donors339Source-to-dashboard mapping + production checklistComms Lead
24Board/leadership blind to pipeline risk3412Monthly risk row in board packetED

That's 24 risks. Notice what rises to the top: key-person dependency (16), restricted funds misuse (15), and donor concentration (15). Those three are chronically under-rated because they're slow-burn, not dramatic. No single bad day makes them obvious — which is exactly why they belong near the top of your heat map. Two of these — reconciliation drift and dispute handling — deserve their own runbooks because they recur constantly. If those are your top scores, build the detailed workflow first: see the audit-ready donation reconciliation workflow and the donation-dispute recovery runbook for the control-level detail that sits underneath register rows #1 and #2.

Writing controls that can actually be tested

A control belongs in your register only if you can answer "did it happen, yes or no?" at any point in the quarter. Here's the test:

  1. Bad control

    "Staff are careful about restricted funds." — Untestable.

  2. Workable control

    "Every gift over $500 is tagged with its fund restriction at intake, and the Finance Lead reviews untagged gifts weekly." — Testable: pull the untagged list, check the review log.

For each control, define three things in a hidden column of your register:

  1. Evidence — what proves it ran (a signed report, a timestamped log, an export)
  2. Frequency — weekly, monthly, quarterly, or per-transaction
  3. Test method — how an auditor or board member would verify it

The under-appreciated move here is sampling. You don't verify every transaction — you pull a random sample each quarter. Ten receipts, five restricted gifts, three disputes. If the sample passes, the control is likely holding. If two of ten receipts are missing IRS substantiation language, your "automated receipts" control has a gap you'd never have found by just assuming it worked.

The board-report rows: mapping incidents to controls and owners

This is the part most registers skip, and it's the part boards actually need. A board doesn't want your full twenty-four-row heat map every month. They want a short, honest section that answers: what went wrong, which control was supposed to stop it, and who's accountable?

IncidentDateRegister Risk #Control That FailedRoot CauseOwnerRemediationStatus
3 donations charged back, no evidence filedMar 2#2Dispute evidence SLAReceipts not saved at gift timeDonations OpsEnable auto-capture of receipt + IPDone
$4,200 restricted gift spent on general opsFeb 18#3Intake fund taggingGift logged by volunteer, untaggedFinance LeadReclass entry + volunteer retrainIn progress
Monthly donor file: 38 silent card failuresMar 10#22Dunning retry workflowNo card-updater enabledDonations OpsTurn on updater + 3-retry logicIn progress

A few things make this format work:

  1. Every incident links to a register risk number. If an incident can't be mapped to an existing risk, that's a signal your library has a gap — add the risk.
  2. "Control that failed" is explicit. This shifts the board conversation from "who messed up" to "which control needs strengthening," which is a far healthier dynamic and keeps staff honest instead of defensive.
  3. Owner is a person, present in the room. The board can ask them directly.

When the same risk number shows up in incident rows three months running, that's not bad luck — that's a control that's structurally broken. Bump its likelihood score and escalate the remediation.

A 5-step process to stand this up in a week

You don't need a quarter-long initiative. A workable register goes live in about a week of part-time effort.

  1. Day 1. Day 1 — Clone the library. Copy the 24-risk table above into a spreadsheet. Delete what doesn't apply (no events? drop #13), add anything specific to your org.
  2. Day 2. Day 2 — Score honestly with two people. Have the development director and finance lead score independently, then reconcile the gaps. Disagreements are where the real conversation lives.
  3. Day 3. Day 3 — Assign named owners. Every row gets a person, not a department. If one name appears on more than six rows, you've just found risk #20 (key-person dependency) in action.
  4. Day 4. Day 4 — Define evidence and frequency per control. For each control, write down what proves it ran and how often. Skip the test method for now if you're short on time.
  5. Day 5. Day 5 — Build the board row template. Set up the incident table. Backfill it with any incident from the last 90 days so the board sees it working on day one.

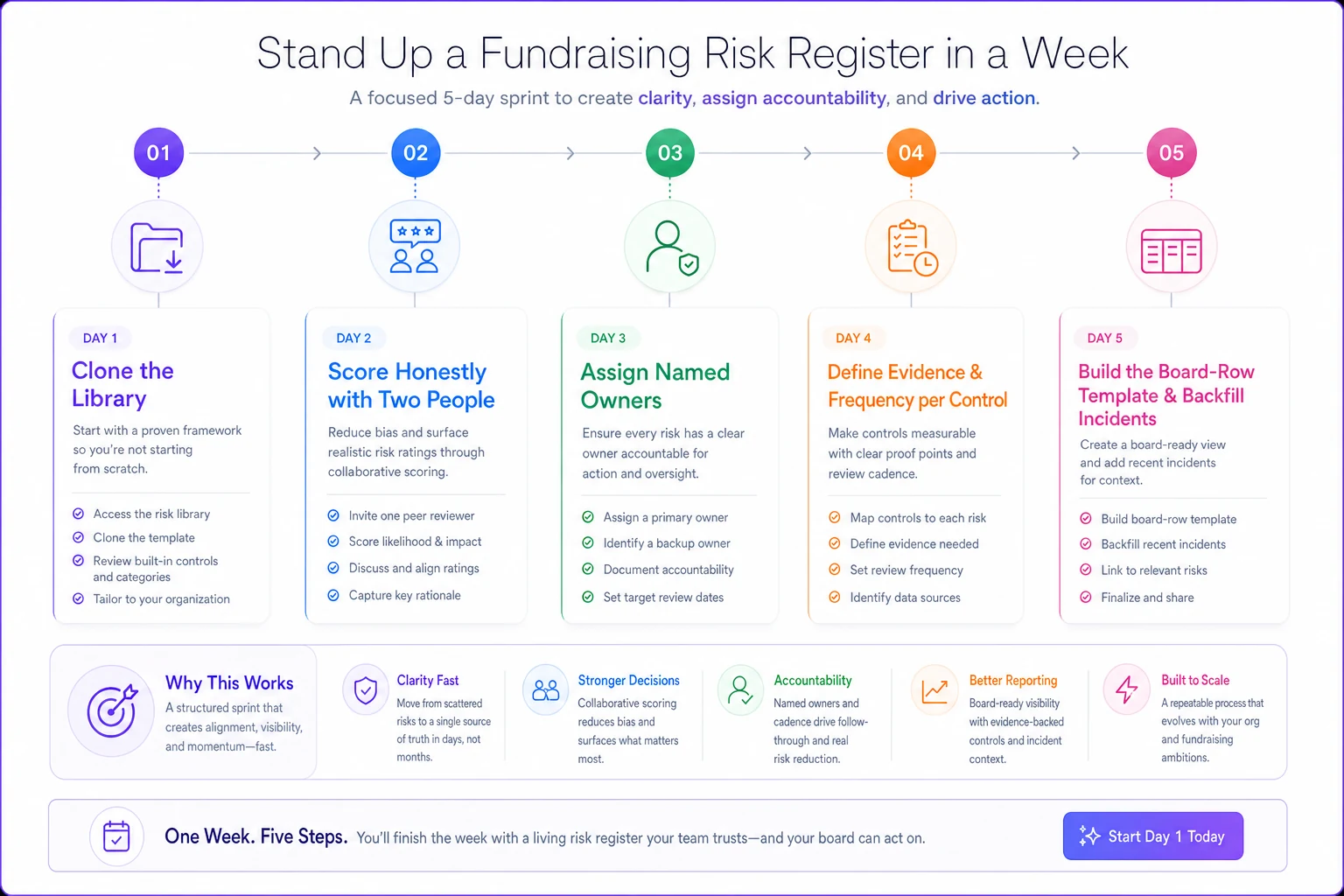

Process diagram

This visual shows the week-long setup workflow.

When a formal register makes sense (and when it's overkill)

This makes sense when you're processing gifts across multiple channels, managing restricted or grant funds, or when your board has started asking risk questions and nobody has a clean answer. The moment you have grant compliance obligations, the register stops being optional.

This is overkill when you're an all-volunteer org raising under ~$50k a year through one channel. At that scale, a one-page checklist of your top five risks beats a twenty-four-row register nobody maintains. Don't build governance theater you can't sustain.

Who should not do this alone: if you're the only person who touches the CRM, the finances, and the donor relationships, don't build the register solo and file it. The highest-scored risk in your own org is probably you being the single point of failure. Build it with your treasurer or a board member so the accountability is genuinely shared.

A short real scenario

A mid-sized arts nonprofit — roughly $900k annual revenue, three-person development team — kept getting surprised by restricted-fund issues at audit time. Each year the auditor flagged a few thousand dollars of restricted gifts that had drifted into general operations, and each year it was a scramble to reclass entries and explain it to the board.

They built a register off a library like this one. Nothing fancy — a spreadsheet, twenty-two rows, named owners. The two changes that mattered: fund tagging moved to intake (control for risk #3), and they added a single risk row to every board packet. The following audit cycle, restricted-fund corrections dropped from around $4k–$6k to a couple hundred dollars of genuine edge cases. More telling, the board stopped learning about problems at the annual meeting and started seeing them month to month, when they were still fixable. The register didn't eliminate risk. It just made risk visible early enough to be cheap instead of expensive.

Keeping it alive

The register only works if it's a living document. Set a recurring 30-minute monthly review: update any likelihood scores that incidents changed, close out remediations, and confirm each top-five control actually ran that month. Most of this is pulling an export and checking a log — the kind of repetitive verification that's easy to automate once your CRM and payment data are connected, so flagged exceptions land in front of an owner instead of waiting to be discovered.

Automate the monthly control checks with scheduled exports and a simple script to flag missing evidence.

The orgs that get value from a fundraising risk register nonprofit process aren't the ones with the prettiest heat map. They're the ones who treat it as an operational feedback loop: incident happens, control gets traced, owner gets notified, score gets updated. Do that consistently and the register earns its place — not as the thing you build before an audit, but as the thing that quietly keeps the audit boring.

The orgs that get value from a fundraising risk register nonprofit process aren't the ones with the prettiest heat map. They're the ones who treat it as an operational feedback loop: incident happens, control gets traced, owner gets notified, score gets updated. Do that consistently and the register earns its place — not as the thing you build before an audit, but as the thing that quietly keeps the audit boring.

Built for Fundraisers Tailored tools for nonprofit and donor management workflows
Save Time Consolidate donor data, automate reporting, and streamline campaigns
Engage Donors Personalized communication and real-time donation insights
Grow Impact Enhance fundraising outcomes and increase donor retention
